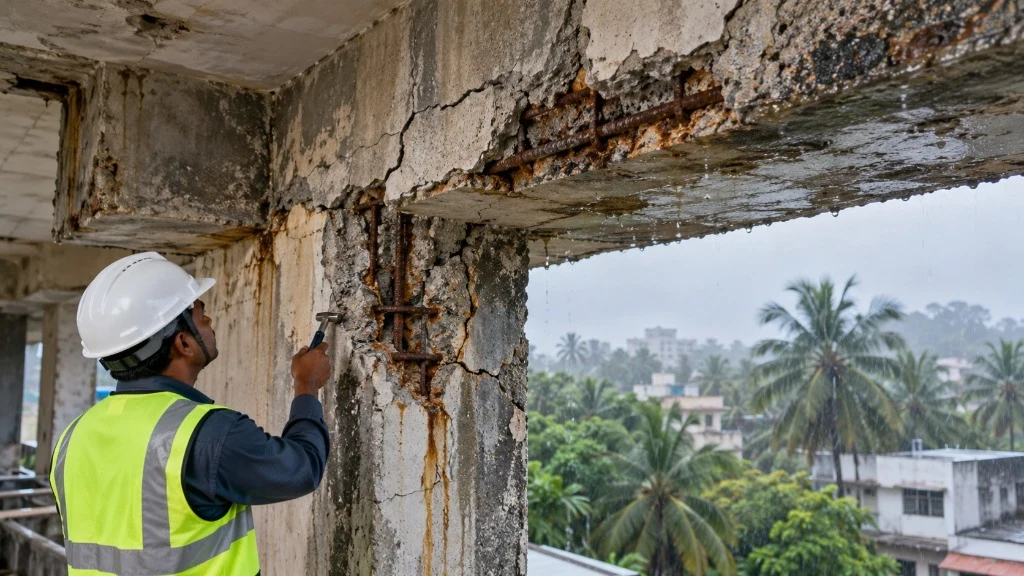

Why Concrete Repairs Fail in Tropical Climates (And What Works Instead)

By Structural Repair & Diagnostics Team
•
Reviewed by Vchemics Technical Team
•
October 2026
•
9 min read

We get some version of this call every monsoon.

"We repaired that column just six months ago. Now the patch is cracking around the edges and there's rust coming through again. Was the cement bad?"

Honestly? It almost never is.

When a concrete repair fails this fast, the material in the bag is rarely the problem. The problem is that the repair was done like a textbook job in a mild, dry climate. And Tamil Nadu is neither. Our heat, our sudden rain and, near the coast, our salty air treat a fresh repair patch far more harshly than most repair guides assume.

The good news is that the fix isn't complicated. You just have to stop treating tropical concrete repair like a cosmetic patch-up.

Why Concrete Repairs Fail: The Short Answer

Concrete repairs in tropical climates usually fail for five reasons:

  1. The patch dries out too fast in the heat and never cures properly.
  2. The surface wasn't ready, so the new material never truly bonds to the old concrete.
  3. The rusted steel underneath was covered up, not treated.
  4. The repair material doesn't match the way the old concrete moves.
  5. Nothing protects the finished repair from the next round of rain, heat and salt.

Fix those five, and a well-done repair can last as long as the concrete around it.

How Tamil Nadu's Climate Attacks a Repair

Here's what I mean by "harsh". It's not just that it's hot.

The surface gets far hotter than the air. On a 38°C afternoon, an exposed terrace slab or a west-facing column in full sun can run well above 50°C. Then a pre-monsoon shower hits and drops that surface temperature by twenty degrees or more in a few minutes.

Concrete moves with every swing. Concrete expands and contracts by roughly 0.01 mm per metre for every degree of temperature change. So a 10-metre terrace that swings 30°C between night and afternoon moves around 3 mm. Every single day. A repair patch has to ride that movement out without letting go of the old concrete.

The code already calls this severe. IS 456, India's concrete code, classes concrete exposed to alternate wetting and drying or to a coastal environment as severe exposure. That's not us being dramatic. That's the national standard telling you a repair here needs to be specified for tough conditions.

Salt air finds the steel. Within a few kilometres of the sea, in Chennai and along the coast, chlorides settle on concrete and slowly work their way in. Chlorides are what turn a little surface rust into real loss of steel.

Think of a repair patch as a new tenant moving into an old building where the walls shift every day. If it can't move with the building, it'll crack. If it isn't properly attached, it'll fall off.

5 Reasons Concrete Repairs Fail (And What Works Instead)

1. The Patch Dries Out Before It Can Cure

Cement-based repair materials need water to gain strength. That's how cement works. But in midday heat with a breeze, water evaporates from the surface faster than the mortar can use it.

You know that moment when you tap a repair and it sounds hollow? This is often where it starts. The mortar shrinks as it dries, fine "crazing" cracks appear within days, the surface turns weak and dusty, and the edges pull away from the old concrete.

What works instead:

  • Do repair work in the early morning or late afternoon, not at 1 pm in April.
  • Shade the area if you can. Even a tarpaulin helps.
  • Keep the repair damp with wet hessian, or apply a curing compound, for the full curing period given on the product datasheet.
  • Don't let the surface dry out between layers.

We wrote about the same problem in fresh concrete pours in our guide on preventing cold joints in hot weather. The heat that rushes a pour also rushes a repair.

2. The Surface Wasn't Ready to Bond

A repair is only as strong as the line where new meets old. Most failed patches we see were placed on a surface that wasn't ready: dusty, oily, crumbly, or carrying a weak top layer.

And there's a sneaky one that catches even experienced crews: bone-dry old concrete. Hot, dry concrete acts like a sponge. It sucks water out of the fresh mortar right at the bond line, the one place you need that water most.

The other classic mistake is feathered edges, where the patch is thinned out to nothing at the sides so it looks neat. Thin edges are the first thing to crack and lift.

What works instead:

  • Break out all loose and weak concrete until you reach sound, hard material.
  • Saw-cut the edges about 10 mm deep, so the patch has a square shoulder to lock into instead of a feathered edge.
  • Clean off dust and debris thoroughly.
  • Pre-wet the old concrete to a saturated surface dry condition, meaning damp right through but with no standing water.
  • Use a bonding agent when the repair system calls for it. The epoxy bonding agents in our concrete repair range need the mortar placed while the bond coat is still tacky, not after it has hardened.

3. The Rusted Steel Was Just Covered Up

If we had to pick the single biggest reason repairs fail, it's this one.

When concrete spalls (when chunks crack and fall off), there's usually rusting steel behind it. Rust takes up several times the space of the original steel, so it pushes the concrete cover off from the inside. Patch over that rust without dealing with it, and the corrosion simply carries on under your nice new surface.

It gets worse. Repair one spot and the steel just outside the patch, still sitting in old, contaminated concrete, can start corroding faster. Engineers call this the incipient anode or "ring anode" effect. It's why you sometimes see fresh cracks right beside a neat old repair, and why owners end up chasing the same problem around a column for years.

What works instead:

  • Cut back behind the reinforcement, leaving roughly 20 mm of clearance, so the repair material can wrap all the way round each bar.
  • Keep breaking out along the bar until you reach clean, uncorroded steel. Don't stop at the edge of the visible damage.
  • Clean the steel to bright metal with a wire brush or by grit blasting.
  • Coat the cleaned steel with a zinc-rich anti-corrosion primer, like the rebar primers in our concrete repair range.
  • If a bar has lost a lot of its thickness, it may need extra steel. That's a decision for a structural engineer.
  • Near the coast, test for chlorides before you decide how far to break out.

4. The Repair Material Doesn't Match the Concrete

A lot of site repairs still use a plain sand and cement mix. It's cheap and familiar, but it shrinks a lot as it dries and doesn't bond well, which is exactly the wrong combination for our conditions.

At the other end, very rigid materials cause their own problems. Epoxy mortars are excellent for some jobs, like small high-strength repairs or areas exposed to chemicals. That's where epoxy grouting systems earn their place. But they expand with heat differently from concrete. Put a large epoxy patch on a sun-baked slab, and the daily temperature swing builds stress at the bond line until something gives.

Maybe it's just us, but "stronger" is the most misleading word in concrete repair. You don't want the strongest material. You want the one that behaves most like the concrete you're repairing.

What works instead:

  • For most patch repairs, use a polymer-modified cementitious repair mortar from a concrete repair range built for it. The polymers improve bonding, add a little flexibility and make the repair less permeable to water and salts. Look for mortars classified under EN 1504-3. Class R3 and R4 are the structural grades, with R4 the highest.
  • For deep or large sections, such as columns, beams, honeycombed areas and jacketing, use a flowable, non-shrink micro concrete poured into formwork, instead of building it up layer after layer by hand. Our column jacketing guide walks through how that's done.
  • Respect the maximum layer thickness on the product datasheet. Going thicker in one pass is how you get sagging, voids and cracks.

5. Nobody Protected the Finished Repair

The repair's done, the scaffolding comes down, everyone's happy. Then the next monsoon arrives and the bare repair, and the old concrete around it, takes the full hit again.

Two slow processes keep working in the background. Carbon dioxide from the air reacts with the concrete (carbonation) and lowers the alkalinity that normally protects steel from rust. And near the coast, chlorides keep working their way in. A repair that's left exposed is a repair on a timer.

What works instead:

  • Finish and cure repairs before heavy rain is due. Planning around the monsoon calendar is half the job.
  • Apply an anti-carbonation or elastomeric protective coating over the repaired area and the surrounding concrete. Look for systems that meet EN 1504-2. Our guide to protective coatings for buildings explains the options.
  • On terraces, treat waterproofing as part of the repair, not an optional extra.
  • If water is actively leaking through a crack, stop it first with PU injection grouting before you patch. A repair placed over running water won't hold.

How to Read a Failing Repair

If you're looking at a repair that's already gone wrong, this table will usually point you to the cause.

What you seeMost likely causeWhat usually fixes it
Fine cracks across the patch within daysDried too fast, poor curingRepair in cooler hours and keep it damp for the full curing period
Patch sounds hollow when tappedPoor bond: dusty or bone-dry surfaceSaw-cut, clean, pre-wet, bonding agent, re-patch
Rust stains bleeding throughSteel not cleaned or primedBreak out behind the bars, clean to bright metal, zinc-rich primer
New cracks right beside an old patchIncipient anode effectExtend the repair along the corroded steel, then coat the area
Large patch lifting on a sunny slabMaterial too rigid or wrong productPolymer-modified repair mortar to EN 1504-3
Deep honeycomb or heavy column damageThick hand-packed layersFlowable micro concrete poured into formwork

The Repair Sequence That Actually Lasts

Put it all together and a durable repair in our climate looks like this:

  1. Find the cause first. Is it a leak, low concrete cover, carbonation or chlorides? A hammer tap survey, a cover meter and a simple carbonation test tell you a lot.
  2. Mark and saw-cut the repair area into simple, square shapes.
  3. Break out to sound concrete, including behind the reinforcement.
  4. Clean and prime the steel.
  5. Pre-wet the old concrete to saturated surface dry.
  6. Apply the bonding coat if the system needs one.
  7. Place the repair mortar, or pour micro concrete for deep sections.
  8. Cure it properly. Shade it and keep it damp for the full curing period.
  9. Protect it with a suitable coating.

You can see how we approach each stage on our concrete repair solution page, and for heavier structural work, our structural rehabilitation page.

When to Call a Structural Engineer First

Let's be clear about one thing. Repair materials are not a replacement for structural design.

If steel bars have lost a significant part of their thickness, if cracks are getting wider, or if a main column or beam is badly damaged, get a qualified structural engineer to assess it before anyone picks up a trowel. The right chemicals make a sound repair last. They can't make an unsafe structure safe on their own.

Here's how our range maps to the five failure points above:

  • Concrete Repair: polymer-modified structural repair mortars, epoxy bonding agents and zinc-rich rebar primers, covering reasons 2, 3 and 4.
  • Micro Concrete: flowable, non-shrink micro concrete for deep sections, column jacketing and honeycombed areas (reason 4).
  • Protective Coatings: anti-carbonation and elastomeric coatings that keep rain, CO₂ and salts off the finished repair (reason 5).
  • Waterproofing Chemicals: for terraces and wet areas, where waterproofing belongs in the repair itself.
  • PU Injection Grouting: to stop active leaks through cracks before any patching starts.

Conclusion

A concrete repair in Tamil Nadu doesn't fail because the climate is impossible. It fails because the repair didn't respect the climate. Slow the drying, prepare the surface, treat the steel, choose a material that moves like your concrete, and protect the result.

Not sure what your site needs? Send us a few photos of the damage and tell us where the building is. Talk to our technical team and we'll help you work out the cause before you spend money on the fix.

Frequently Asked Questions

Why does my concrete repair keep cracking?

Usually because the repair dried out too fast, wasn't properly bonded, or the rusting steel underneath wasn't treated. In hot, humid climates, all three are common. Fix the cause and the preparation, not just the surface.

Can concrete repairs be done during the monsoon?

Yes, but carefully. The repair needs protection from direct rain until it has set and gained early strength, and the old concrete shouldn't have standing water on it. Where possible, plan major repairs to finish and cure before heavy rain is expected.

How long should a concrete repair be cured?

Follow the curing period on the product datasheet, because it varies by product and conditions. Either way, keep the repair damp or use a curing compound, and take extra care in hot, windy weather, when repairs lose moisture fastest.

What's the difference between repair mortar and micro concrete?

Repair mortar is applied by hand or trowel and suits shallower patches. Micro concrete is a flowable, non-shrink material poured into formwork, so it suits deep sections, large areas and column jacketing where hand application would leave voids.

Is epoxy mortar better than polymer-modified mortar for repairs?

Not for most general repairs. Epoxy mortar is very strong and chemical-resistant, but it moves differently from concrete when the temperature changes. For large patches exposed to sun and rain, a polymer-modified cementitious mortar is usually the better match.

Do I need to remove all the rust from the steel?

Yes. Loose rust should be removed until you reach clean, bright metal, and the steel should then be primed. Rust left under a repair keeps growing and will push the new patch off.

Related resources

Explore relevant Vchemics products and solutions

Direct Technical Support

Need help applying this guidance to your project?

Share your project conditions with the Vchemics technical team for product selection, application guidance, or a quotation.

Authorized Distributor / Dealer

Fosroc Authorized Distributor Logo
BASF Construction Chemicals Logo
Master Builders Solutions Logo
Sika Building Trust Logo
Berger Home Shield Scientific Waterproofing Logo
Renacon AAC Blocks Logo
MYK Arment Construction Chemicals Logo
STP Limited Logo
Ardex Endura Logo
Fosroc Authorized Distributor Logo
BASF Construction Chemicals Logo
Master Builders Solutions Logo
Sika Building Trust Logo
Berger Home Shield Scientific Waterproofing Logo
Renacon AAC Blocks Logo
MYK Arment Construction Chemicals Logo
STP Limited Logo
Ardex Endura Logo
